Coordinates |
22º 18' 52" S, 68º 53' 11" W |
22º 18' 56" S, 68º 53' 13" W |
22º 18' 57" S, 68º 53' 13" W |
22º 18' 55" S, 68º 53' 7" W |
News |

March 25, 2019 - Codelco informed this morning its decision to
terminate the contract with SNC Lavalin early on, due to the serious
breach of contractual milestones that the company has incurred in the
construction of acid plants for the Chuquicamata Smelter, works that are
key to adapt the emissions to DS No. 28. Among the non-compliances, are
the delay in payments to its subcontractors, delays in the execution of
the project and problems in the quality of the works, among others.
Codelco developed six major projects to raise the standard of the
Chuquicamata complex, including the construction of two new acid plants,
which was awarded in November 2016 to the SNC Lavalin company. The
contract for an approximate amount of US$260 million included the
detailed engineering, the supply of equipment and the construction and
assembly of the same (EPC). Through a letter sent to the company
this morning, the Corporation reproached him for the serious and
repeated breach of the obligations imposed by the contract. It should be
noted that Codelco made several attempts to resolve the difficulties
that the project was experiencing, the last of which was last February.

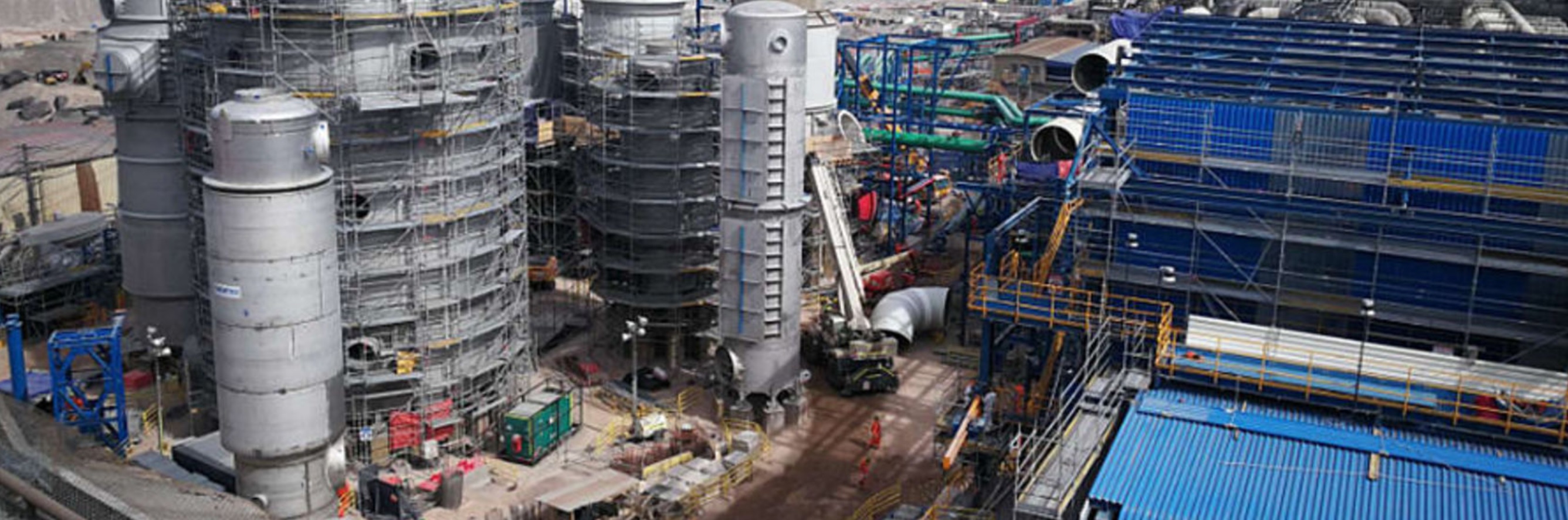

In the near future, Codelco will begin the transfer of the first new
acid plant to the Chuquicamata smelter to begin the empty tests,
adjustments and resolution of conditions that guarantee a safe
operation. Subsequently, with an estimated difference of 15 to 20
days, the operation will be normalized with the entry into operation of
the second sulfuric acid plant and its review process for each part and
adjustments to the set for an adequate operational condition.
February 27, 2019 - Chilean copper
giant Codelco's Chuquicamata smelter is expected to restart operations
in April after shutting down in December for upgrade works needed to
comply with new emissions rules, local press reported. New
regulation came into effect in Chile on December 13 requiring copper
smelters to capture at least 95% of the arsenic present in emissions
gases. Codelco had been working for some time on a US$2bn program to
upgrade its four smelters but works were not complete at Chuquicamata or
the Salvador division smelters by that date and both were halted. Half
of the total investment is going to Chuquicamata. The upgrade
program had originally been estimated to require US$1bn. Codelco
"believes we will be in a position to start the launch at the beginning
of April, making the necessary efforts to absorb the effects of the
meteorological events of early February," a Codelco representative said,
according to local daily Mercurio de Calama. The Chuquicamata mine and
other copper operations in northern Chile were halted due to heavy
rains at the beginning of the month. Works at the Chuqui smelter
include the construction of two acid plants. During the smelter
stoppage, Codelco has been forced to sell copper concentrates, leading
to daily losses of US$41mn, the paper reported. Codelco was not
immediately available for comment. Chuquicamata produced 137,000t
in 1H18 and is undergoing an underground conversion to expand production
and extend its life, which is Codelco's most advanced strategic project.
March 31, 2017
- MECS Inc., a wholly owned subsidiary of DuPont, has been selected to
supply the sulfuric acid production technology for two new plants belonging
to Corporación Nacional del Cobre de Chile (Codelco), the world's largest
copper producer. The MECS technology will treat off-gas from the
Chuquicamata Copper Smelter Complex in the Antofagasta region of northern
Chile. Longtime MECS partner, SNC-Lavalin, will provide detailed
engineering, procurement and construction services for the new plants each
of which is expected to produce 2048 t/d of market-grade sulfuric acid.
These plants will replace existing facilities which have become
environmentally obsolete. "MECS technology for Chuquicamata will be
designed and custom-built to address the site's specific needs, especially
achieving world-class low emissions and high reliability," said Kirk Schall,
executive vice president, MECS. "We are delighted that our best-in-class
sulfuric acid production technology will help Codelco's Chuquicamata site
realize its short- and long-term emissions targets while supporting the
sustainable production of the Antofagasta region's most valuable resources.
MECS looks forward to partnering with both Codelco and SNC through start-up
and with Codelco throughout the life of the new facilities."
Construction of the two new plants will begin in 2017 and is expected to be
completed the following year. |
