Construction - Transportation
January 26, 2018

Truck
        Gas-to-Gas Heat Exchangers
        Converters
        Towers

        FRP Equipment
        Ducting
Ocean Freight
Associated Links

Truck

On the journey from fabricator to plant site, virtually 100% of all equipment will be move by truck at some stage of the journey.  There are a variety of trucks available designed to carry virtually any load.  Factors affecting truck transportation are:

Gas-to-Gas Heat Exchangers

Gas-to-Gas heat exchangers are some the heaviest pieces of acid plant equipment that will need to be transported.   Shipping limitations will sometimes dictate the size of the exchanger or whether or not the unit is split into two shells.  Tubing of the exchanger on site may also be required due to weight limitations of the available trucks or road restrictions.

Multi-axle trailers are required for most exchangers.  Special escorts and temporary roads closure may be required due to the size of the equipment.

Converters

construction_transconv1.JPG (14279 bytes) construction_transconv2.JPG (10639 bytes) construction_transconv4.JPG (11490 bytes)

Converters are most often field fabricated due to its large size.  In a few rare cases a converter can be shop fabricated when the plant is small and there are few if any shipping restrictions.  These photos show the shipment of the bottom section of a stainless steel converter.  The load is extremely wide blocking off both lanes on the highway.

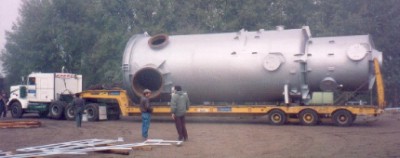

Towers


If a drying or an absorbing tower is small enough to be shop fabricated and then shipped to site, it will save a lot of time during construction.  Towers are simply empty shells.  The weight is not high but the size of the tower makes it difficult to transport.  The gas inlet nozzle is often left off during transportation because it sticks out from the round shell and may cause the load to exceed shipping limits.

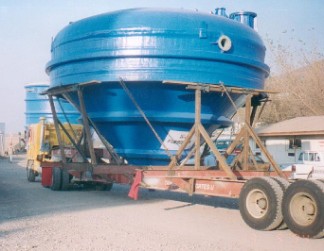

FRP Equipment

construction_transfrp1.JPG (16030 bytes) construction_transfrp2.JPG (27970 bytes) construction_transfrp3.JPG (14430 bytes)
construction_transfrp4.JPG (24357 bytes) construction_transfrp5.JPG (23148 bytes) construction_transfrp6.JPG (26374 bytes)

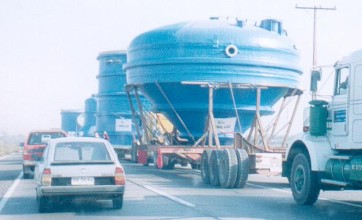

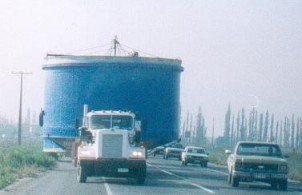

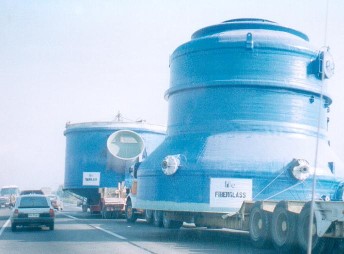

It is desirable to fabricate FRP equipment in as large a piece as possible to avoid field fabrication and field joints on the shell of major vessels.  This results in the need to transport large vessel.   The advantage of FRP equipment is its lightweight for transportation. Transportation of the large vessels often requires traffic restrictions as illustrated above.


Ducting

Gas ducting will generally be fabricated in the shop in spools that can be shipped.  The length and size of the spools will depend on the shipping restrictions.  Ducting is not heavy but comes in ackward shapes that must be supported to avoid damage to the ducting.

Maximizing the amount of shop fabrication will minimize the erection time required and the overall cost of the project.  Expansion bellows, dampers, reinforcing rings, brackets, etc. should all be spooled up with the duct in the shop.  All expansion joints should be equipped with brackets to prevent movement of the expansion joint during shipment.  The photo illustrates how two elbows in the same plane can be spooled up with all the attachments and still be shippable on a flat-bed truck.





Ocean Freight

Ocean freight is required when equipment is manufactured in one country and must be shipped to another country half way around the world.   Virtually anything can be shipped by ocean freight due to the variety of ships available.

Heat exchangers fabricated in Canada are shipped to site in a special self-loading ship.  The exchangers are stored below deck.  Cargo covers are in the process of being removed in the photo on the right.  The exchangers were shipped without the tubes installed due to weight limitations.  The exchangers will be off-loaded by the ship's crane onto the waiting trucks.

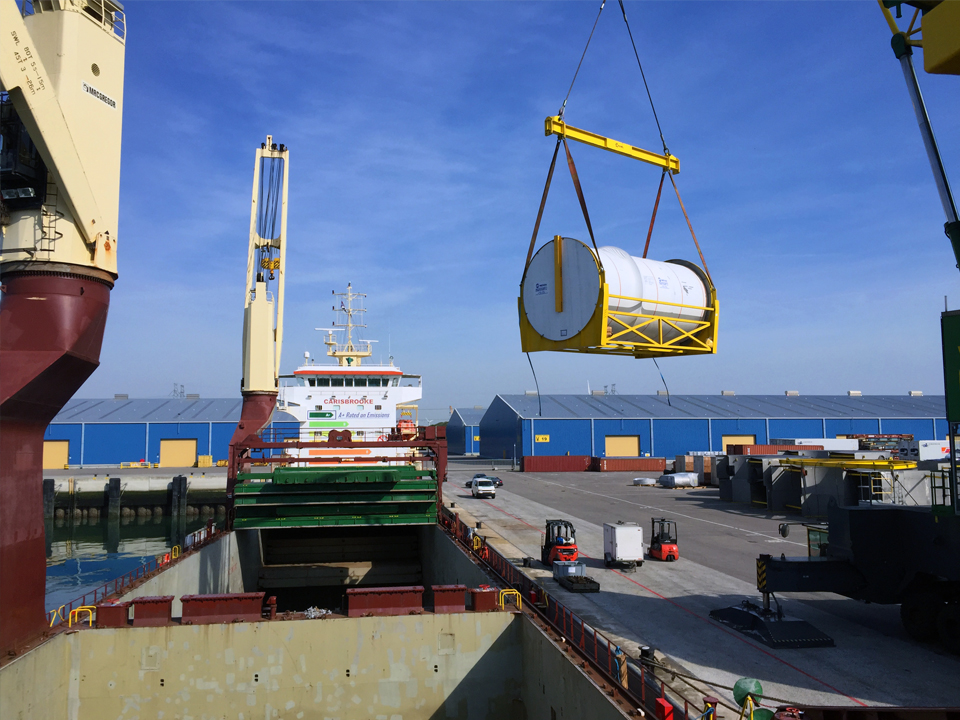

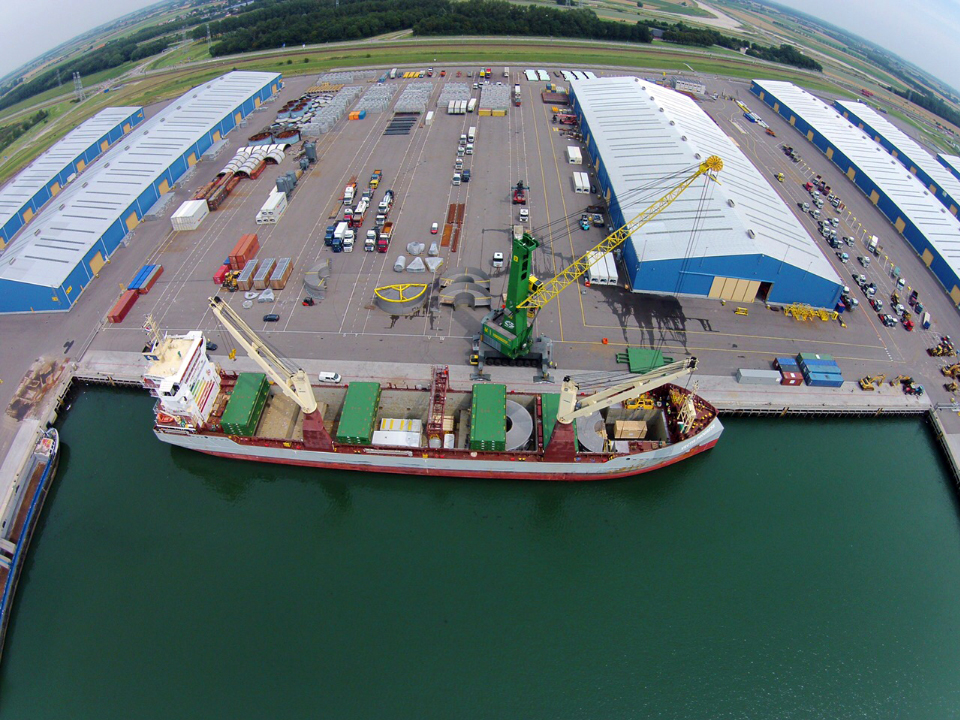

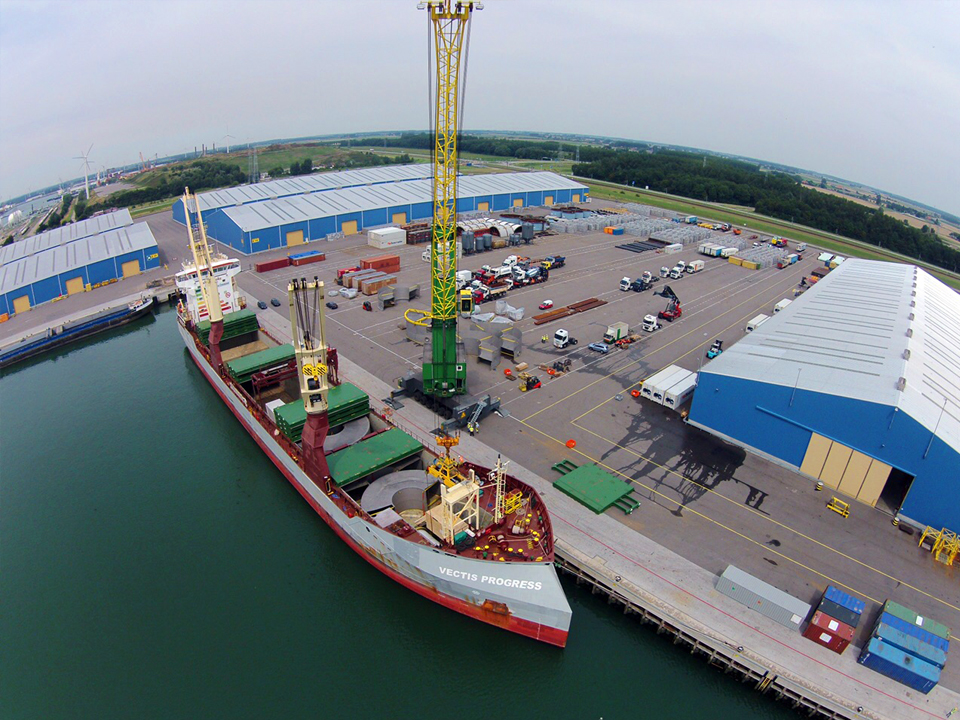

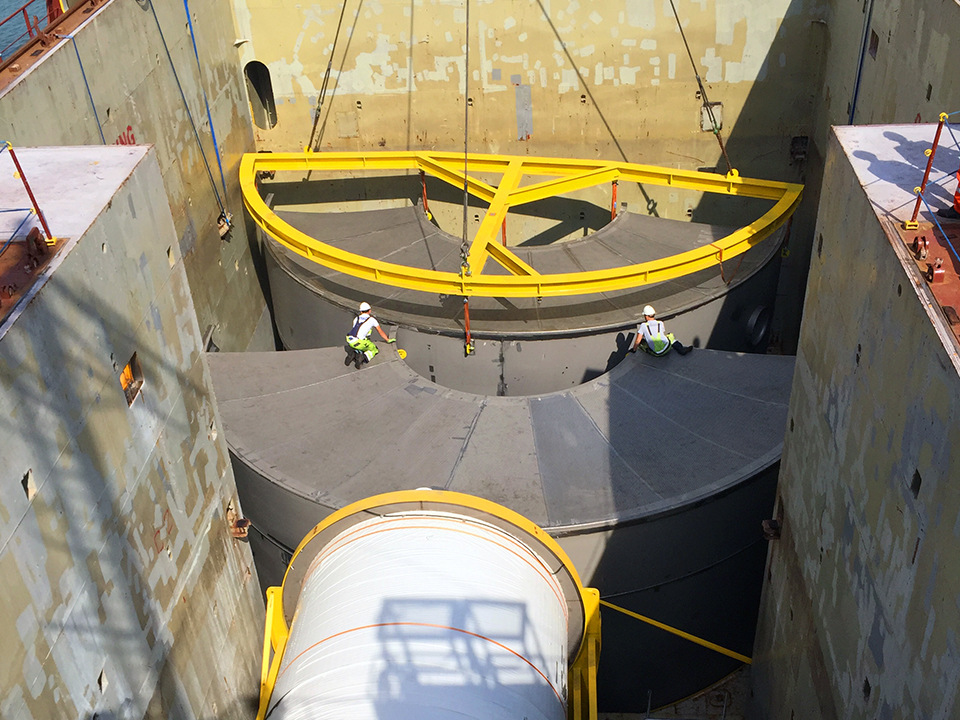

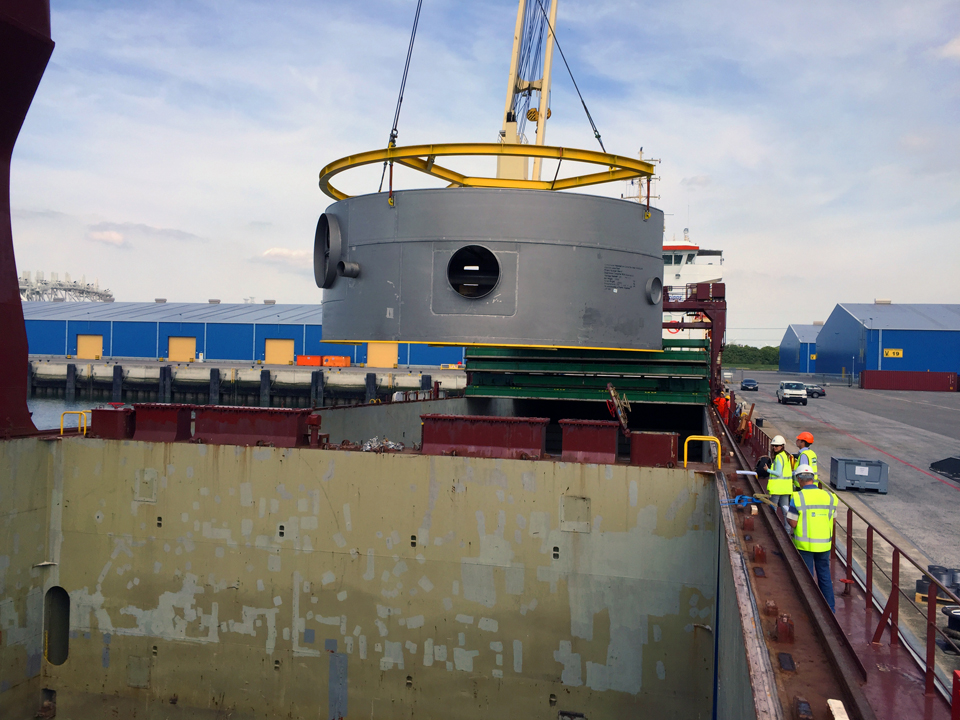

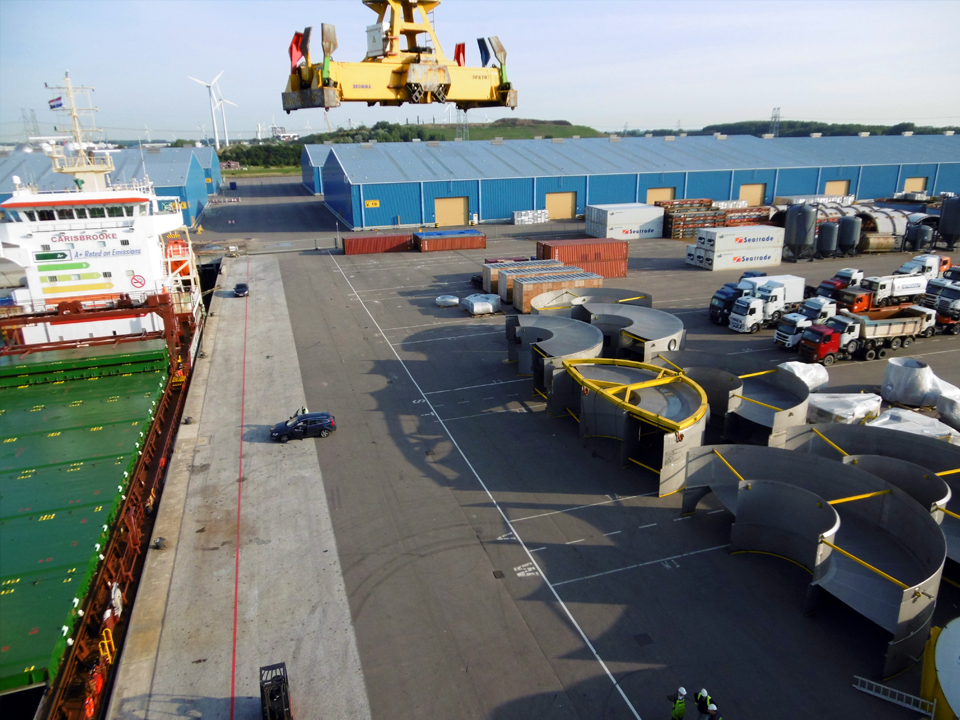

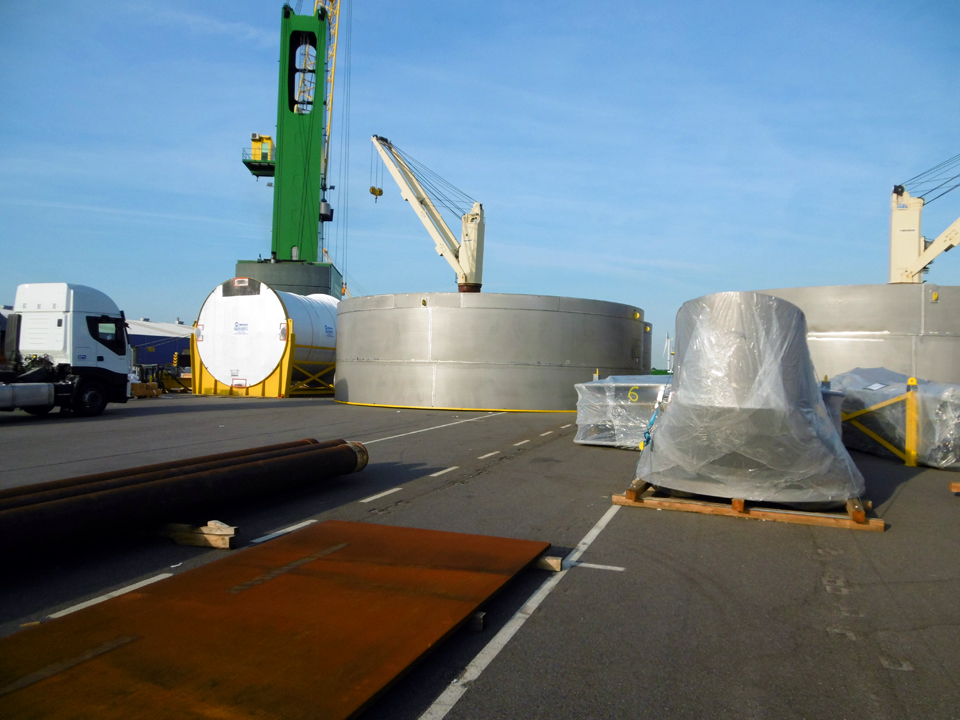

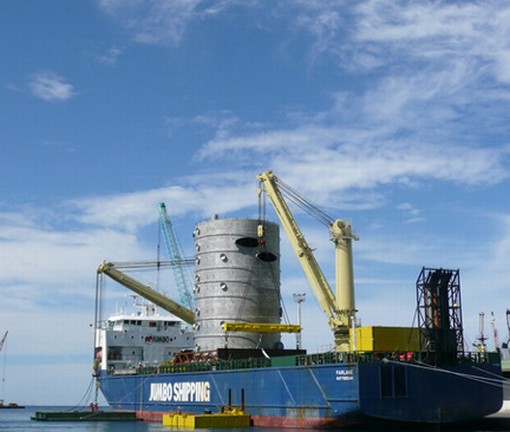

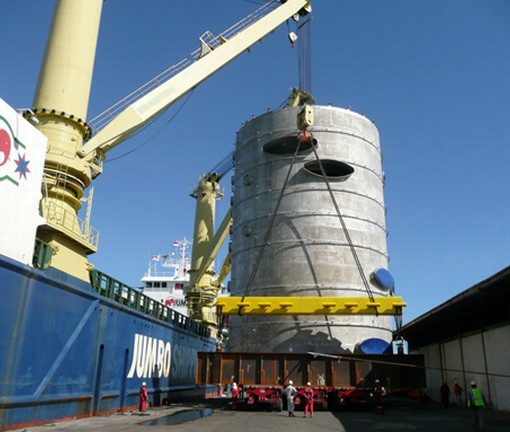

Converter shipment for the Ambatovy Nickel Project in Madagascar

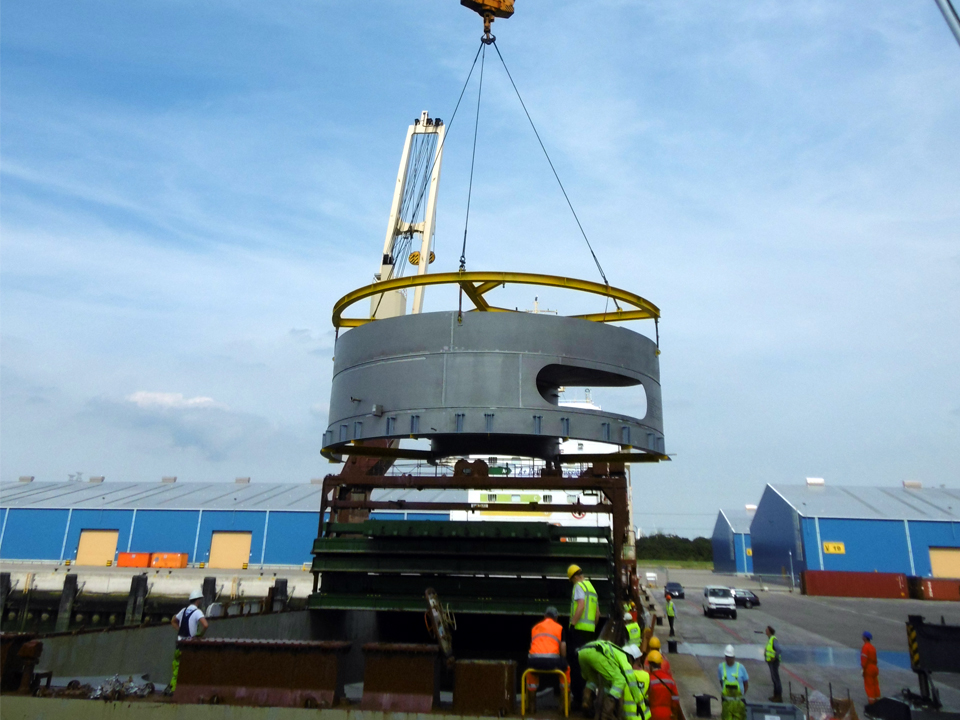

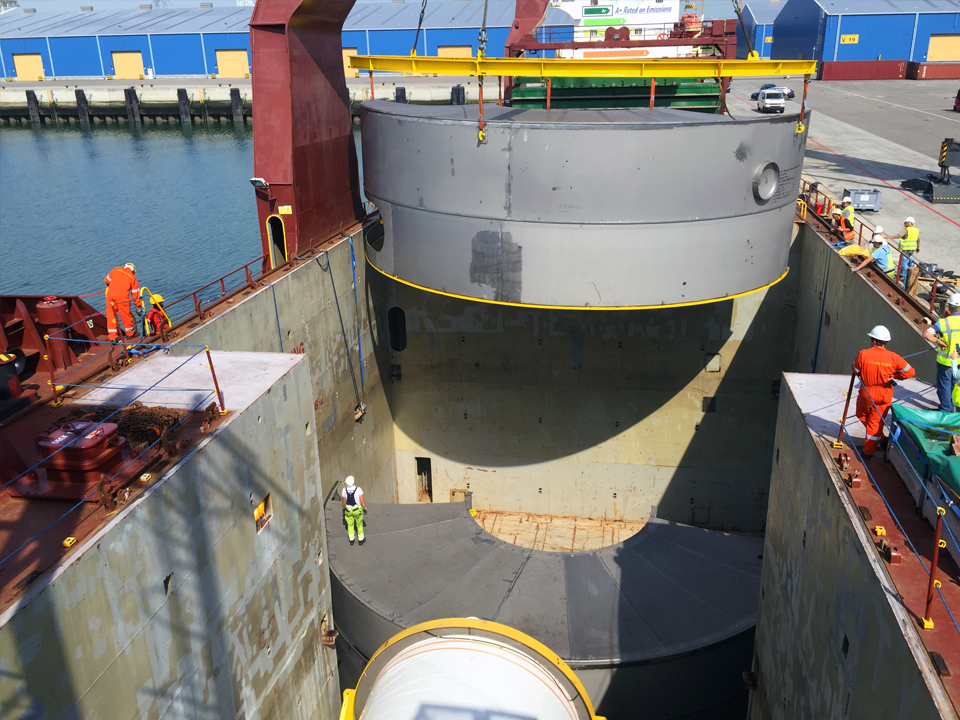

Martin Bencher Germany loaded 4,960.00 FRT of equipment in the Netherlands for a Sulphuric Acid Plant destined for Chile.Largest items:

10 Converter Units: each app. 13.50 x 7.05 x 4.90 m / each app. 24.00 mton
1 Heat Exchanger: 9.80 x 5.45 x 5.40 m / 55.00 mton

www.martin-bencher.com
